Decorative Lighting Samples are used to establish the accuracy of the design, materials and surface finishes, electrical performance, installation structure, packaging and transportation prior to mass production. If the product is new, a hotel project, or a complex custom-designed luminaire, a solution that seems to work on drawings may actually turn out to be problematic during prototype development, for example due to clearances in the assembly, limited driver space, variation in the surface color, compatibility with dimming systems or installation problems on site.

This article covers projects that need to be prototyped first, what the sample should prove, how to check the quality of the sample, and what specifications and documents are frozen upon sample approval. It also presents real project cases of how to avoid discrepancies between approved samples and mass production.

1. Why Decorative Lighting Projects Require Prototyping

The following is important before discussing the sample stage approval process: Identify which projects need to be prototyped and what the important items are to verify at the sample stage.

Lighting Fixture Prototyping

Lighting Fixture Prototyping

1) Which Projects Should Be Prototyped First?

In the case of products that have constant specifications, it is possible to manufacture them directly provided that the materials, electrical setting and manufacturing process do not change, for long-term mass production. If a project is new product development, structural change, material change or custom engineering, however, the sample approval process should be completed prior to mass production. The following are typical projects types to prototype first.

Project Type Prototype Recommended Primary Purpose
Standard mass-produced products Depends on the project Mature manufacturing process with proven production experience
Modified dimensions or proportions Recommended Verify structural design and installation dimensions
Material or surface finish changes Recommended Confirm color, texture, and finishing quality
Newly developed products Required Validate design and manufacturing feasibility
Hotel and commercial custom projects Strongly recommended Reduce the risk of large-scale rework

2) What Can a Prototype Verify?

A prototype is used to test if the full product is ready for production and if it is suitable for manufacturing, installation and maintenance. On the manufacturing point of view, the sample basically confirms the following aspects: Design accuracy, Manufacturing process, Structural assembly, Electrical performance, Packaging and transportation. This covers dimensional deviation, assembly clearance, quality of surface finish, uniformity of light output, compatibility for dimming, load-bearing capacity, retention of safety and installation compatibility on site.

The design, for instance, calls for an assembly gap of 3 mm between the glass and the metal frame. Once the prototype has been produced, normal dimensional variation of the blown glass can make proper assembly of the prototype impossible. In the other case, the LED driver is OK, but it does not fit into the system’s upper structure design, so the upper structure needs to be redesigned when installing. If these are recognized in the prototyping process, only one sample needs to be changed. They can cause rework of the entire order if found later in the mass production process.

3) How Does Sample Approval Reduce Mass Production Risks?

The purpose of sample approval is to solve all possible issues which could lead to a dispute before mass production and not during the production process. In engineering projects, upon approval of the sample, all production is to equal this sample. All the dimensions, materials, surface finishes, light source configurations, lighting effects and installation methods should be consistent with the approved sample.

Once the sample is approved, three important references are set for mass production. First, it fixes materials, manufacturing process, light source and driver configuration. Second, it establishes tolerances for size, color, assembly and lighting. Thirdly, it establishes a common inspection criteria between client and supplier. During the project the approved sample and its supporting documents will be used as a reference for production inspection, delivery acceptance, and quality dispute resolution.

2. What Should Be Verified During Decorative Lighting Sample Evaluation?

When ordering light fixtures for decoration, make sure that dimensions, materials and workmanship, lighting performance, installation and maintenance are all checked at once with custom decorative light fixture. Once all of these essential elements are in compliance with the project requirements the approved sample can then be used as a basis for mass production.

Lighting Fixture Sample Verification

Lighting Fixture Sample Verification

1) Appearance and Dimensions

Appearance verification is to ensure the finished product has the correct appearance, proportions, curves and overall symmetry, and the physical fixture is the same as the design rendering. Dimensional (verification) should include the use of calipers and tape to check overall length, width, height, curve radius and mounting hole spacing, and ensure that all tolerances are met.

Postmodern Lighting defines dimensional tolerances according to part size and manufacturing method. For example, standard dimensions for small and medium-sized metal components are typically controlled within ±1 mm, precision assembly parts within 0.5 mm, and CNC-machined mounting holes within 0.3 mm. Larger welded structures, hand-blown glass, and natural materials require individually specified allowable tolerances.

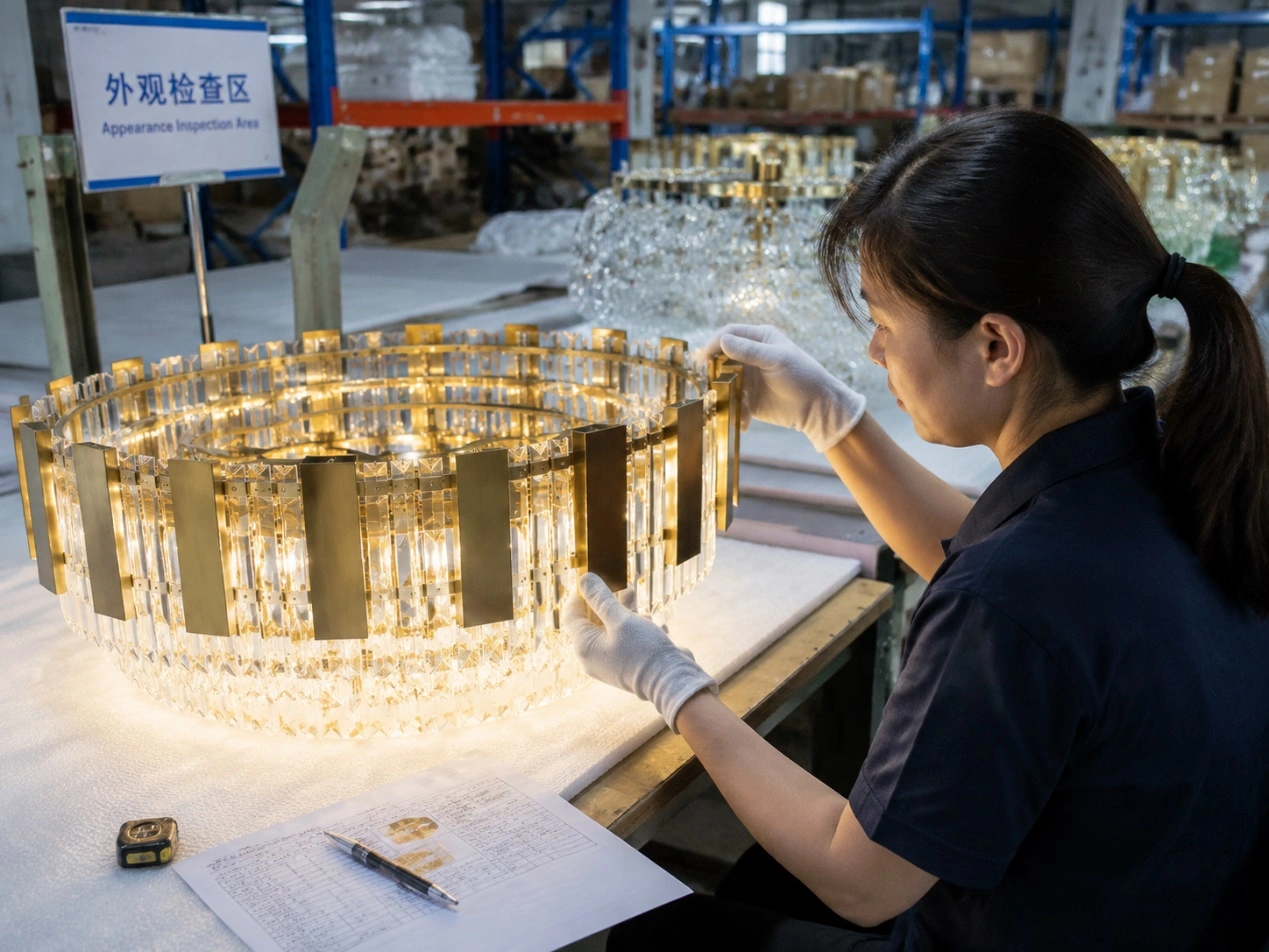

Appearance Inspection

Appearance Inspection

For example, a lobby chandelier may be manufactured exactly to the drawing dimensions, but if the suspension rod proportion is too short, the installed fixture can appear visually too low compared with the space rendering. The product itself may have no quality defect, but the structural proportions still need to be adjusted.

2) Materials and Surface Finishes

Make sure to verify materials during the sample stage, instead of just determining if it looks similar in color. Verify that the specified material grades match the physical components: distinguish between 201, 304, and 316L stainless steel; standard glass and low-iron extra-clear glass; and confirm whether metal structures use sheet, tube, profile, or solid sections, including the actual wall thickness and cross-sectional dimensions. Inspect for colour, surface texture, gloss, uniformity, surface finishes paint, powder coating, electroplated, PVD or PVDF (fluorocarbon) coating, and for pinholes, orange peel, powder loss, scratches and any local colour variations.

For instance, assume a specification calls for “Brushed Brass,” each manufacturer may employ brushed solid brass, or electroplated brass or PVD brushed brass and the resulting color and texture will be different. Natural marble can be provided to the material specification, however there will still be natural pattern variation between each slab. The acceptable range should, therefore, be verified at the sample stage and not be put in question at the mass production stage.

Material Surface Finish

Material Surface Finish

3) Light Source Effect and Lighting Performance

Light source verification should not just encompass colour temperature and brightness levels. It should also certify light uniformity, glare control, colour rendering and dimming. The light that is created by many fixtures installs in a different way than it does in a factory or laboratory and creates a different light effect in the actual space.

A sample of a chandelier to be tested in a hotel lobby, for instance, might be a 3000K LED and be bright enough during factory tests. Once installed in an 8 m tall lobby, however, the illuminance can clearly be seen as insufficient and therefore a higher lumen output and a different driver configuration will be needed. In engineering projects, the height and environment during testing should therefore as closely as possible be reproduced with the installation.

Light Source Effect Comparison

Light Source Effect Comparison

4) Structure, Installation, and Maintenance

The product should be suitable for installation and efficient maintenance, as well as the sample itself. When performing structural checks, the emphasis should be on the section assembly, opening clearances, cable routings, and heat dissipation space to ensure that there are no interference points, complicated disassembly, or loose wires. For suspended, ceiling or wall mounted fixtures, installation verification must emulate the complete installation process and verify compatibility with embedded fixture mounting points, range of suspension rod adjustment and load-bearing stability.

For instance, in the case of a chandelier, the fixture may comply with all of the appearance and lighting requirements, but the driver will only be removed from the front of the ceiling canopy, which will necessitate removal of the whole fixture for maintenance. Once the sample is optimized, the driver can be shifted to an independent maintainable structure without losing any appearance, and with a much better maintainability in the future.

Lighting Fixture Installation Test

Lighting Fixture Installation Test

3. How to Evaluate the Quality of a Decorative Lighting Sample

Apart from appearance and dimensions, the manufacturing workmanship, electrical performance and packaging and transportation should also be verified according to the end delivery. These inspections will only be passed if the sample passes the tests, which will then serve as a reliable reference for future mass production.

1) Appearance Quality Inspection

Appearance inspection is not only about whether the product looks acceptable. In fact, it sets the standard for mass production. Items to be covered in a key inspection include: overall proportions, color consistency, metal joints, welding positions, glass texture, crystal arrangement and surface defects (including scratches, dents, pinholes, runs and color variation). When natural stone, hand-blown glass, or other natural materials are used, specify an acceptable range of texture and colour variations in advance, to prevent natural material characteristics being incorrectly regarded as quality defects.

2) Manufacturing Workmanship Inspection

The sample indicates if the manufacturing process is matured and is used as an important basis to determine if the product is appropriate for mass production. When inspecting, ensure welds are smooth, metal to metal connections are tight, assembly clearances between parts are even, moving parts function well, and assembly and removal is easy.

For large chandeliers, a simulated installation is also recommended to confirm whether the fixture segmentation is reasonable, the on-site installation sequence is clear, and individual modules can be replaced independently. Many projects skip installation verification during the sample stage and only discover after mass production that some parts cannot be installed or removed, leaving factory rework as the only solution.

3) Electrical and Functional Testing

The electrical review should record the input voltage, total fixture wattage, color temperature, color rendering index, driver model, and dimming protocol. Test start-up and shut down, dimming synchronize, flicker and abnormal noise at rated output and minimum dimming level required by the project.

For projects using control systems such as DALI, 0–10V, or Casambi, connect the sample directly to the specified control system during the sample stage instead of simply checking whether the fixture turns on. In actual projects, some incompatibility issues between drivers and control systems are only discovered during on-site commissioning, resulting in driver replacement and rework.

4) Packaging and Transportation Protection Verification

The sample stage must ensure that the product is accurate, as well as the appropriateness of the packaging solution.

Verify the size of the packaging, cushioning materials, construction of the wooden crate, separate glass or crystal parts, and part numbering. Also, for export projects, verify the packaging can be used for air freight, sea freight or full container load and verify if they can be efficiently handled and installed on site. The chandeliers that are required to be large and decorative are typically packed in modules, and each part of the chandelier is given a corresponding installation number to minimize installation time and errors.

4. Common Problems During Sample Approval

Based on Postmodern Lighting’s previous project experience, the following issues are frequently overlooked during prototyping, can lead to losses in mass production, and often cause disputes between suppliers and customers. Corresponding solutions are provided below.

1) Approving the Sample Only Through Mobile Phone Photos, Without a Physical Approved Sample, Resulting in Uncontrolled Color Variation in Mass Production

Actual problem: The sample is approved through mobile phone photos or screen previews. But the color and texture may be different from both sides because of the difference in the color temperature and brightness of the screens. Samples might look good in photographs but when the production batch comes in there may be some variations in colour or texture than expected, resulting in arguments on who is at fault.

Solution: Mobile phone photos can support communication during development, but they should not serve as the sole basis for final color acceptance. Formal sample approval should use a physical sample and compare it under agreed lighting conditions. For uniform finishes such as spray coating and PVD, define an acceptable color-difference range. For hand-applied antique finishes and natural materials, acceptance should be based on the approved sample together with an agreed range of allowable texture variation.

2) One Fixture Looks Acceptable, but Multiple Fixtures Produce Uneven Light and Shadow Patterns

Actual problem: One sample is normal and has an acceptable colour temperature and brightness when turned on. However, once several fixtures have been installed the space can be clearly seen to have colour patches and uneven brightness. Single fixture testing will not give a true indication of the batch consistency and, in some cases, the factory may use higher quality light sources for the sample and standard light sources for mass production.

Engineering experience: For batch projects, create or find 2-3 fixtures from the pilot batch and set up two of them to test together. Not judge the whole batch based on a single fixture, but judge the colour temperature, brightness, dimming synchronisation and consistency of light and shadow.

Lighting Consistency Comparison

Lighting Consistency Comparison

3) Materials and Configurations Differ Between the Approved Sample and Mass Production

Actual problem:The final BOM doesn’t contain the material wall thickness, surface finish, LED or the driver employed within the sample. In mass production, other specifications or substitutes are used which results in the structural strength, appearance of surface and lighting effect deviating from the approved sample.

Solution:The inspection report and BOM must include the material grade, the thickness of the walls, the surface finishing system, the LED parameters and the driver brand and model. Keep the whole Golden Sample and make sure to keep necessary material swatches and dis-assembly photographs. At production inspection, pick up randomly produced fixtures and inspect inside material and electrical connection.

4) Load-Bearing and Safety Retention Details Are Overlooked, Leaving the Sample Without Safety Verification

Actual problem: Some groups only take note of the lighting and appearance of the display but forget the load-bearing, safety retention structure, and compatibility of attachment to the hanging or embedded supports that create heavy fixtures. The sample might be nice to look at and perform normally, but after mass installation it may not be able to withstand the necessary load or may not have an independent safety cable.

Solution:Heavy chandeliers should be tested during the sample stage for total fixture weight, number of suspension points, load on each point, connection hardware and independent safety retention. Perform a static load test, following project requirements or applicable standards. The project structural engineer should confirm the site-embedded supports and load-bearing structure.

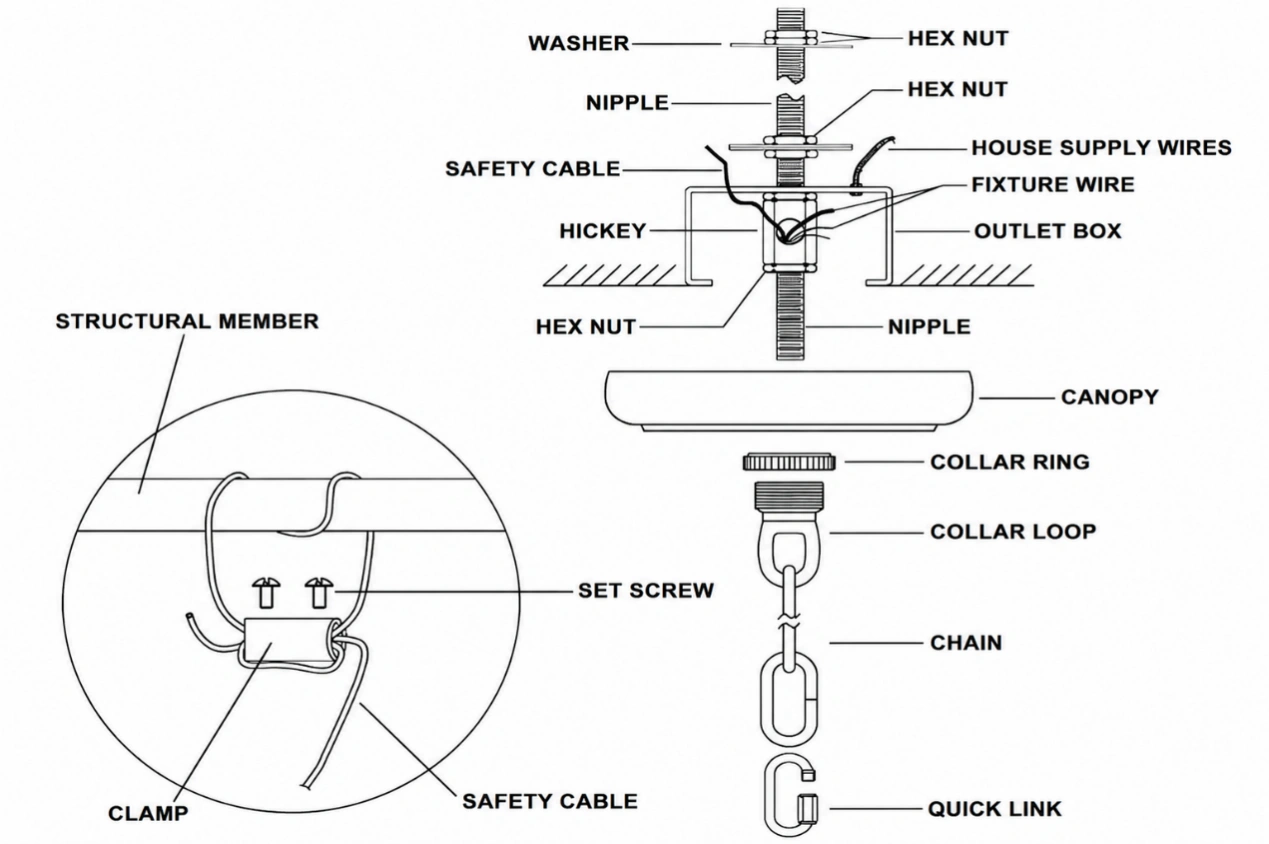

Lighting Fixture Safety Load-Bearing Design

Lighting Fixture Safety Load-Bearing Design

5) Dimming Is Tested Only for Basic Adjustment, Without Verifying System Compatibility

Actual problem:When it is powered on, the sample can be dimmed normally, which can be considered as normal. Once in mass production, problems like unstable dimming, dropouts, network connection failure, unsynchronized brightness and so on could appear.

Solution:Relate the sample to the same control system as the project. Test start up and shut down, minimum brightness, scene switching, multi-fixture sync, flicker performance within the driver’s rated dimming range. Only approve the sample when it has been determined that the controller, driver, and fixture configuration are compatible!

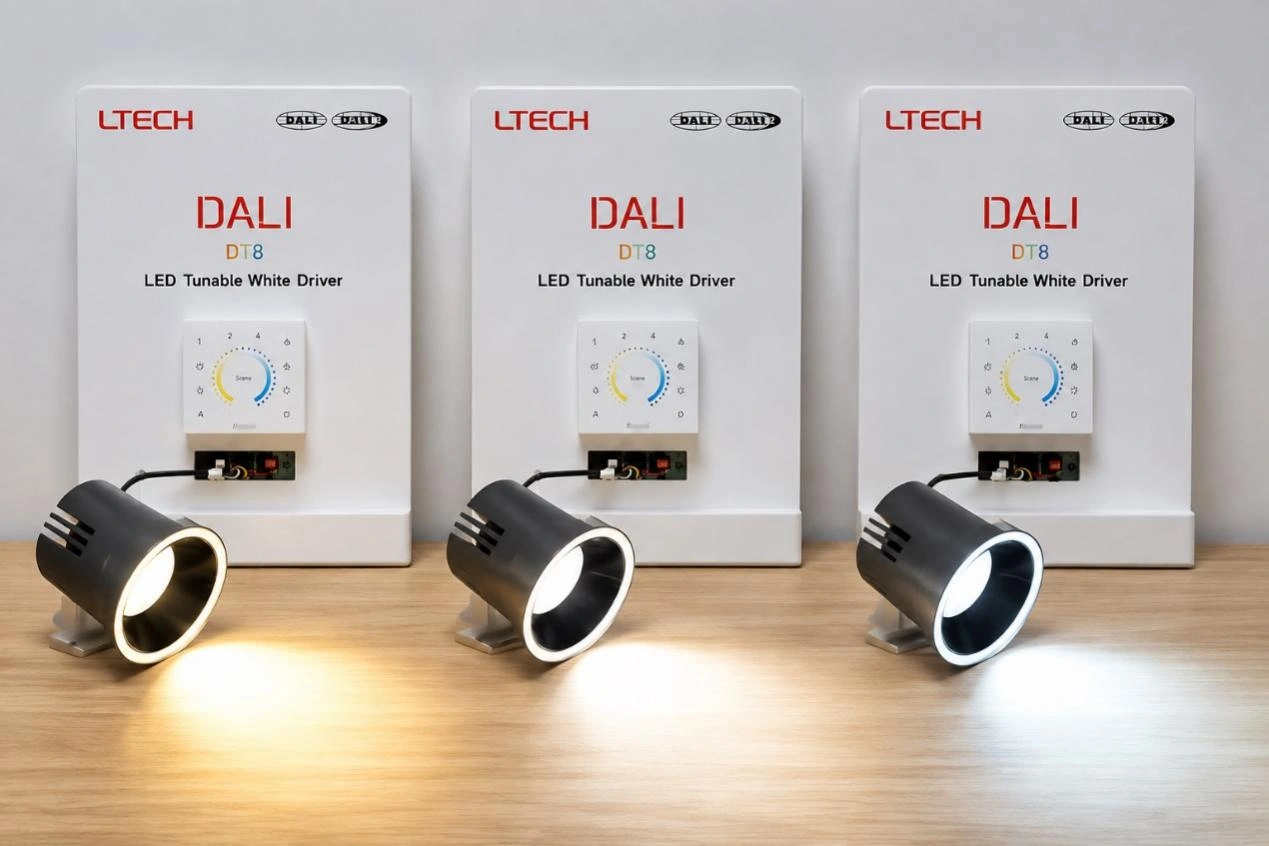

Lighting Fixture Compatibility Test

Lighting Fixture Compatibility Test

6) The Sample Dimensions Are Correct, but the Fixture Still Cannot Be Installed on Site

Actual problem: The overall fixture dimensions are checked, but the positions of the holes in the ceiling canopy, embedded support locations, dimensions of the junction box, and range of adjustment of the suspension rods are not checked. Within the building, the canopy may not completely enclose the junction box, or the mounting holes may not line up with the embedded bolts or the suspension rods may not fit the actual ceiling’s height.

Solution: During the sample stage, complete one simulated installation according to the site drawings. Consider the size of the ceiling canopy, the positioning of the holes, the points to hang the canopy, the junction box, clearance from ceiling when hanging, and the range of adjustment. After verifying the installation structure, make sure to include the structure in the final drawings as the foundation for mass production.

5. What Must Be Frozen After Sample Approval?

If the sample is accepted, any changes to materials, structure, or electrical configuration could impact both the quotation and delivery schedule and certification. These should therefore be frozen at the same time:

1) Final Specification Confirmation

Once samples are approved, verify final product specifications such as product size, material, surface finishes, light source, voltage, color temperature, dimming, installation structure, packaging solution and more. Be sure to keep production drawings the same as the approved sample. Changes to any specification should be re-assessed to check if they impact on pricing and/or lead time.

2) Revision Records and Version Confirmation

Sample review comments and changes should be combined into a single Revision List and then documented on the drawings, BOM, specification sheet and renderings, not confirmed by email or in chat. Since there are going to be changes, make sure to update the revision number after each change so the factory can stop producing it based on the old version.

In the case of engineering projects, the final signed drawing should be the only document being produced to prevent production errors from several versions of the same document being used concurrently.

3) Sample Approval

Sample approval confirms more than whether the product can proceed to production. It also defines the acceptance standard for future mass-produced fixtures. At approval, confirm the following items at the same time:

  • Appearance and dimensions meet the final requirements;
    • Materials, colors, and surface finishes match the approved samples;
    • Light source, voltage, color temperature, and dimming method are correct;
    • Installation structure and accessories are complete;
    • Packaging method meets transportation requirements.

Retain one approved Golden Sample as the unified reference for subsequent mass production, inspection, and after-sales comparison. Keep multi-angle detail photos, lighting photos with lights on, workmanship details and test data reports. In the event of a quality dispute at a later stage the approved sample should be used as the basis for evaluation.

4) Final Confirmation Before Mass Production

Before formal mass production, the manufacturer should submit the final Production Package for confirmation. This should include production drawings, BOM, material list, surface finish requirements, packaging solution, and label information.

In addition, for export projects confirm certifications, nameplate, instructions for use, outer carton labels, and shipping marks to prevent rework due to documentation or labelling errors after production is completed.

Mass production must be initiated after all details regarding product specification, production documents and packaging information are completely confirmed. This usually helps to minimize further changes, delays and quality issues.

6. Case Study: How to Complete a Full Decorative Lighting Sample Review

In this case, a 1200 mm ring-shaped, decorative chandelier was received for a hotel lobby and the full dimensional inspection, corrective actions and final sample approval and filing were conducted.

1) Basic Project Information

The application is an interior lobby in a five star hotel and high end commercial lighting. Must be made of 304 stainless steel, have a black powder coated finish, a 3000K high-CRI warm light source, a smooth 0–10V dimming function, a silent and flicker-free operation and a heavy-duty suspension structure with independent safety retention. Prototyping requirement: One 1:1, full sized physical sample with the same configuration as the intended mass production standard.

2) First-Round Sample Receipt and Item-by-Item Review

The review team (design, engineering, procurement) carried out a full inspection under standard lighting conditions and at a height of 3.8 m, simulated in the on-site installation. The approved sample acceptance criteria for this project were ΔE ≤ 1.5, gaps between joints ≤ 0.5 mm and colour temperature of the samples 3000K ± 50K. At the first inspection four nonconforming items were identified:

a)Appearance and workmanship: Minor pinholes were observed in localized areas in the powder coated surface. The same batch color difference was found (ΔE = 2.2) which was more than the acceptable limit (≤ 1.5).
b) Structural details: The maximum gap between the joints was 0.8 mm, which is beyond the recommended limit of 0.5 mm; a slight misalignment was observed at the local level between the adjoining sections.
c) Optical performance: Coloured temperature measured: 3060K (out of tolerance); Note dark areas in places on the luminous surface.
d) Safety details: The sample included only the primary suspension rods and did not have an independent stainless-steel safety cable, so it did not meet the safety requirements for a heavy-duty fixture.

3) Targeted Corrective Action and Second Sample Verification

A written list of corrective actions was given for the first round findings and the factory corrected the sample item by item. The corrective work comprised recoating of the finish, calibration of colour consistency with same batch material, precise adjustment of the joint structure, replacement of LED modules with same batch modules and tighter colour tolerance, and installation of an independent load-bearing safety retention system. After the revised sample was completed, the team carried out a second verification:

a)The appearance: There were no pinhole or coating loss found. The colour difference was ΔE = 1.2 and no pinholes or exposed substrate were observed.
b) Structure: Joint gaps were even and ≤ 0.4 mm and there was no misalignment or deformation. The positions of the mounting holes were consistent with the dimension drawing of the embedded mounting approved.
Optical performance: Color temperature obtained was 3020K, CRI obtained is Ra = 93, dark areas and flicker were not observed in the fixture. The project required illuminance uniformity that was met.
d) Electrical performance: No instability and smooth 0-10V dimming across the entire range. The driver provided isolated electrical safety, with no abnormal current-related noise.
e) Safety: The independent safety retention structure was complete, and the fixture passed static load verification in accordance with the load test plan approved for the project.

4) Final Sample Approval, Documentation, and Production Lock

Once all the sample acceptance conditions were fulfilled, the three parties signed and sealed the approved sample. At the same time, the project records were completed and retained, as were multi-angle detail photographs, dimensional parameter sheets, material and workmanship specifications, optical test reports, safety test records, and the corrective-action acceptance checklist.
